MARKET QUESTION
What is the addressable retrofit market for automated shore-power connection equipment at Mediterranean Ro-Ro and ro-pax berths through 2032?
The commercial decision
Whether an equipment supplier should build a dedicated Mediterranean commercial programme, which port groups to prioritise and how much installation capacity to reserve.
Why the market is difficult to size
- A port count does not reveal how many individual berths are suitable for automated connection equipment.
- Shore-power availability, vessel call patterns, berth geometry and electrical interfaces mature on different schedules.
- Publicly announced projects do not always disclose the connection method, procurement package or installation year.
Scope boundary
INCLUDED
EXCLUDED
Automated cable-management and vessel-connection equipment, berth-side integration and commissioning at eligible Ro-Ro and ro-pax positions.
Grid reinforcement, substations, vessel retrofits, civil works outside the berth package and container-only or cruise-only terminals.
214
berth positions screened
49
base-case procurement berths
EUR 41.7m
2027-2032 cumulative market
Illustrative model output. Values demonstrate the analytical structure and are not presented as a published market total.
MODEL ARCHITECTURE
Regulatory Berth Conversion Model
MODEL EQUATION Berth positions x operating relevance x shore-power timing x automated-connection fit x procurement year x system value

How existing information enters the model
EVIDENCE LAYER | WHAT IS ASSEMBLED | MODEL ROLE |
|---|---|---|
Berth universe | Port directories, terminal layouts and Ro-Ro service patterns | Creates the position-level denominator |
Conversion eligibility | Shore-power projects, electrical interfaces and berth configuration | Removes berths that cannot support the package |
Procurement timing | Funding awards, tenders, planning milestones and construction windows | Moves demand into realistic contract years |
System value | Equipment scope, integration content and comparable berth packages | Separates connection equipment from full port infrastructure |
WHY THIS APPROACH FITS The denominator, eligibility rules, timing mechanism and value logic are specific to this decision. A published headline market is used only as a reasonableness check, never as the calculation route.
ILLUSTRATIVE MODEL OUTPUT
The market is a sequence of berth conversions, not a regional CAGR

What the model indicates

- Only 49 of 214 screened berth positions enter the base procurement window after operating relevance, project timing and physical fit are applied.
- The base case produces EUR 41.7 million of cumulative equipment and integration value from 2027 to 2032.
- Annual revenue peaks when port programmes cluster. A six-year cumulative range is therefore more decision-useful than a smooth growth rate.
Scenario range
SCENARIO | MODEL OUTPUT | CONDITION |
|---|---|---|
Downside | EUR 27m | Slower port awards and more manual connections |

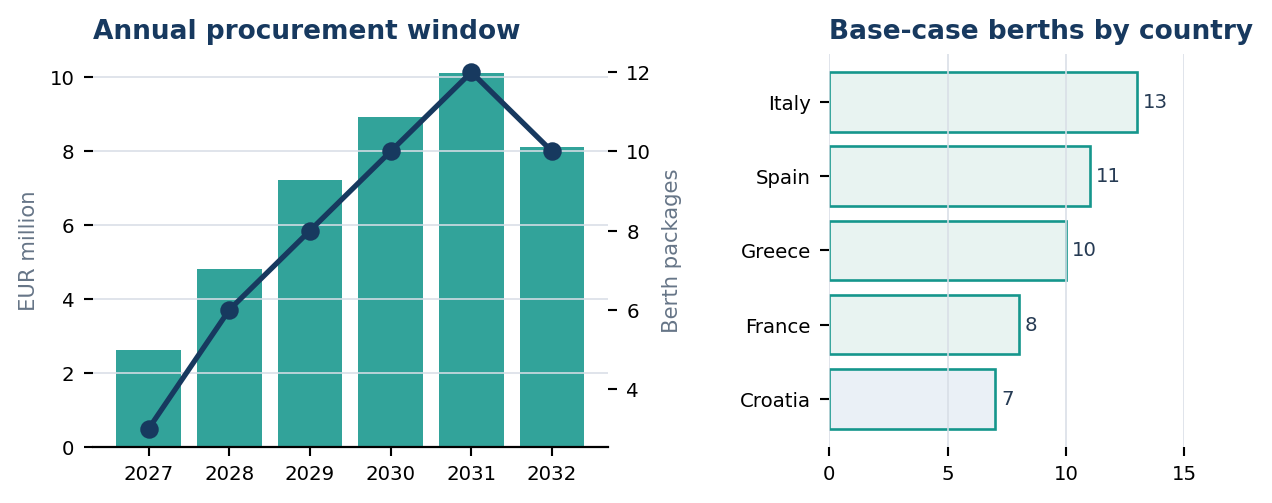

Base | EUR 41.7m | 49 berth packages proceed in the modelled window |
Upside | EUR 56m | Earlier funding and broader automation fit |
INTERPRETATION The range changes named model parameters. It is not created by adding an arbitrary percentage above and below the base case.
DECISION IMPLICATIONS
What the market model changes
DECISION A focused commercial programme is supportable, but capacity should follow named berth programmes rather than a generic Mediterranean sales target.
Recommended commercial response
- Prioritise terminal groups with several eligible berths and a shared electrical architecture.
- Separate early design support from later equipment revenue so the opportunity is not overstated.
- Track funding and tender milestones as leading indicators; vessel traffic alone cannot time the market.
Uncertainty and refresh triggers
TRIGGER | WHY IT MATTERS |
|---|---|
Port award timing | Moves berth packages between years |
Connection specification | Changes automated-equipment eligibility |
Integration scope | Changes average value per berth |
Vessel compliance path | May reduce or accelerate shore-power use |
What August Research would deliver
- Berth-level opportunity ledger
- Country and port-group prioritisation
- 2027-2032 procurement forecast
- Base, upside and downside capacity plan
