MARKET SIZING & FORECASTING | ILLUSTRATION 05

Energy-Efficient Rail Switch-Heating Retrofits in the Nordics

Forecasting retrofit demand from heated-switch stock, climate exposure, control architecture and tender cycles.

MARKET QUESTION
What is the retrofit demand for energy-efficient switch-heating controls across Sweden, Norway and Finland through 2032?

The commercial decision

Whether a supplier should invest in a Nordic retrofit offer, which installed-asset cohorts to prioritise and how tender timing affects production capacity.

Why the market is difficult to size

  • Rail networks report route length more consistently than the number, age and control design of heated switch assets.
  • Cold exposure, traffic criticality and existing sensor architecture determine the value of an energy-control retrofit.
  • Procurement occurs through asset programmes and tenders, producing replacement waves rather than smooth annual demand.

Scope boundary

INCLUDED

EXCLUDED

Controllers, weather and rail sensors, communications integration and commissioning for eligible existing switch-heating installations.

Complete turnout replacement, new-line construction, traction power, manual snow removal and routine replacement of heating elements alone.

12,900
heated switches modelled

2,250
base-case retrofits through 2032

EUR 47.1m
six-year cumulative market

Illustrative model output. Values demonstrate the analytical structure and are not presented as a published market total.

MODEL ARCHITECTURE

Climate-Weighted Asset Replacement Model

MODEL EQUATION Heated switch stock x climate and traffic priority x control compatibility x replacement or tender year x retrofit package value

Illustrative model output. Values demonstrate the analytical structure and are not presented as a published market total.

How existing information enters the model

EVIDENCE LAYER

WHAT IS ASSEMBLED

MODEL ROLE

Installed stock

Infrastructure records, technical standards and asset references

Builds the heated-switch denominator

Priority score

Climate exposure, traffic criticality and energy intensity

Ranks where efficiency and reliability matter most

Retrofit fit

Controller age, sensor architecture and communications compatibility

Separates retrofit candidates from full replacement

Tender timing

Frameworks, renewal programmes and procurement calendars

Converts eligible stock into annual demand

WHY THIS APPROACH FITS The denominator, eligibility rules, timing mechanism and value logic are specific to this decision. A published headline market is used only as a reasonableness check, never as the calculation route.

ILLUSTRATIVE MODEL OUTPUT

The addressable stock is large, but tender cadence controls revenue

Illustrative model output. Values demonstrate the analytical structure and are not presented as a published market total.

What the model indicates

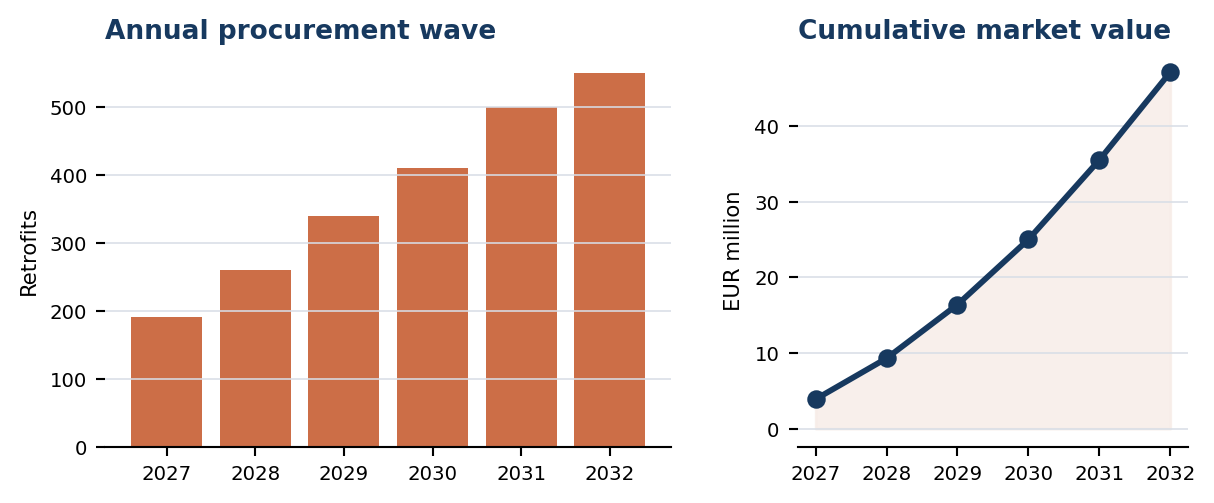

  • The model starts with 12,900 heated switches, identifies 7,700 controller-compatible assets and places 2,250 high-priority retrofits in the 2027-2032 procurement window.
  • The base case produces EUR 47.1 million of cumulative retrofit value.
  • Market timing is more sensitive to programme release and package scope than to changes in the underlying switch stock.

Scenario range

SCENARIO

MODEL OUTPUT

CONDITION

Downside

EUR 38m

Tender delays and narrower control-only packages

Base

EUR 47.1m

2,250 retrofits enter the six-year programme

Upside

EUR 61m

Faster frameworks and broader sensor integration

INTERPRETATION The range changes named model parameters. It is not created by adding an arbitrary percentage above and below the base case.

DECISION IMPLICATIONS

What the market model changes

DECISION A Nordic offer is attractive when aligned to named asset programmes and controller architectures, rather than promoted as one uniform regional market.

Recommended commercial response

  • Prioritise climate-critical and high-traffic cohorts with compatible legacy controls.
  • Build production planning around framework release dates and annual call-off volumes.
  • Separate control retrofits from full turnout renewal so the opportunity is not double counted.

Uncertainty and refresh triggers

TRIGGER

WHY IT MATTERS

Framework timing

Moves revenue between years

Retrofit package scope

Changes average value per switch

Compatibility rate

Changes the serviceable installed base

Energy-management policy

Changes priority and payback thresholds

What August Research would deliver

  • Heated-switch asset ledger
  • Climate and compatibility prioritisation
  • 2027-2032 replacement-wave forecast
  • Tender and package-value sensitivity model

CONTACT US Tell us which market decision must be supported, the scope currently being counted and where available estimates fail to explain the opportunity. August Research will build the boundary, evidence routes and forecast around that decision.

Let’s Discuss Your Project

If a similar decision is ahead of you, August Research can build a Market Sizing & Forecasting engagement around the conditions that matter most.

Get in Touch →
