ELECTRIC UTILITIES | UNITED STATES

Locating the constraints behind transformer availability

A Critical Component Capacity Stack for a multi-state grid programme

CLIENT DECISION Which component and facility bottlenecks are extending distribution-transformer availability, and where can procurement action change the schedule?

Background

A utility group planning replacement and grid-expansion work needed to distinguish market-wide lead-time commentary from the specific constraints affecting its transformer classes. The decision was how to sequence orders, specifications and supplier development across a 30-month programme.

1,480
PLANNED UNITS

30
PROGRAMME MONTHS

31
PLANTS REVIEWED

11
COMPATIBLE FACILITIES

ILLUSTRATIVE ENGAGEMENT | The organisation, scope, figures, findings and conclusion below show how the service can be applied. They do not describe an actual client engagement.

RESEARCH DESIGN

Critical Component Capacity Stack

Demand was translated into transformer classes and then into component requirements. For each class, the model layered effective plant capacity, material allocation, production constraints, specification compatibility and committed demand to reveal the first binding bottleneck.

01

Segment unit demand

Separate pole-mounted, pad-mounted and higher-capacity requirements.

02

Decompose the build

Map electrical steel, cores, windings, tanks, bushings and labour dependencies.

03

Screen compatible plants

Apply voltage, efficiency, certification, size and delivery constraints.

04

Stack effective capacity

Adjust nominal output for allocation, changeovers, labour and committed orders.

05

Sequence procurement

Match order timing and specification choices to the binding constraint.

Evidence assembled

• manufacturer plant and product data
  • energy and trade statistics
• material and component capacity evidence
  • public procurement and utility filings
• freight and border-route indicators
  • client specifications and project demand

INDEPENDENT VALUE A common evidence structure reconciles internal records with external entity, facility, trade, capacity and event evidence. Assumptions that cannot be confirmed remain visible rather than being converted into false precision.

DEPENDENCY FINDING

Plant count overstated the capacity available to the programme

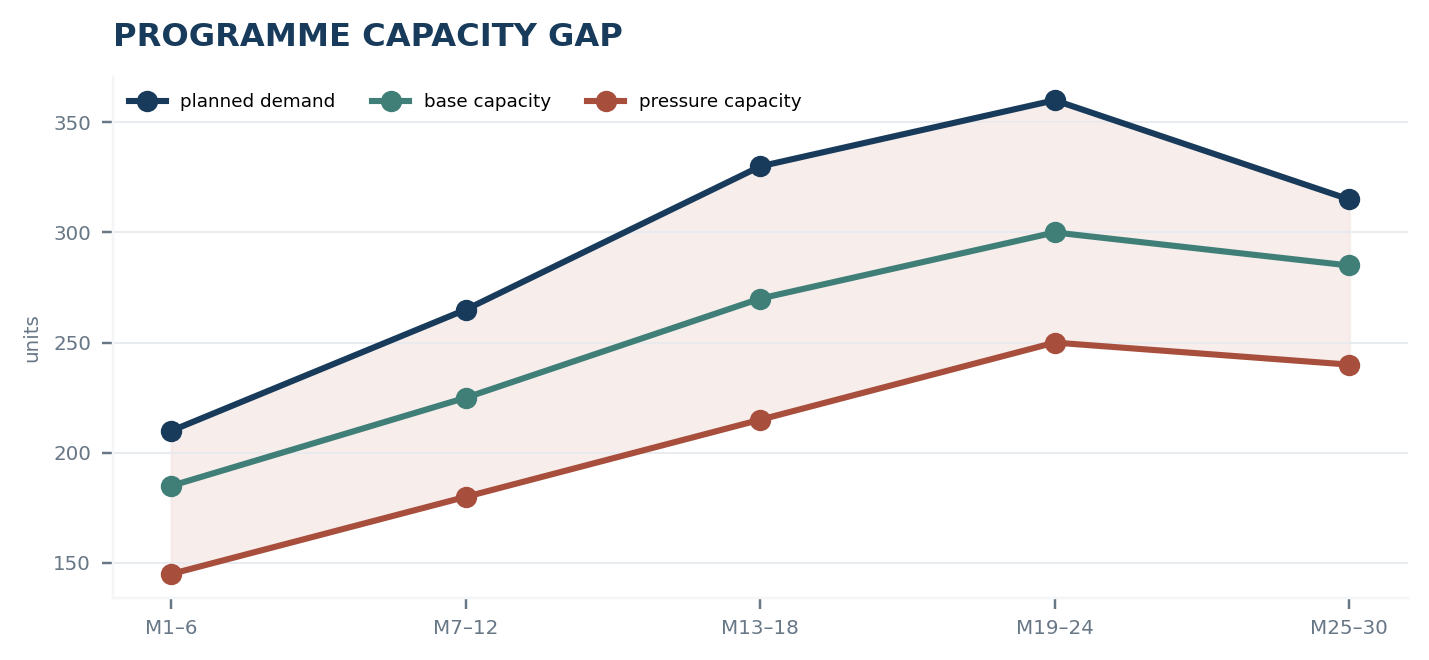

Thirty-one plants appeared relevant at the market level, but only eleven could support the required combinations of transformer class, efficiency, certification and delivery geography. Effective capacity covered 0.82x of base demand and 0.63x under the pressure case.

  • Compatibility filters reduced the relevant plant universe from 31 to 11 facilities.

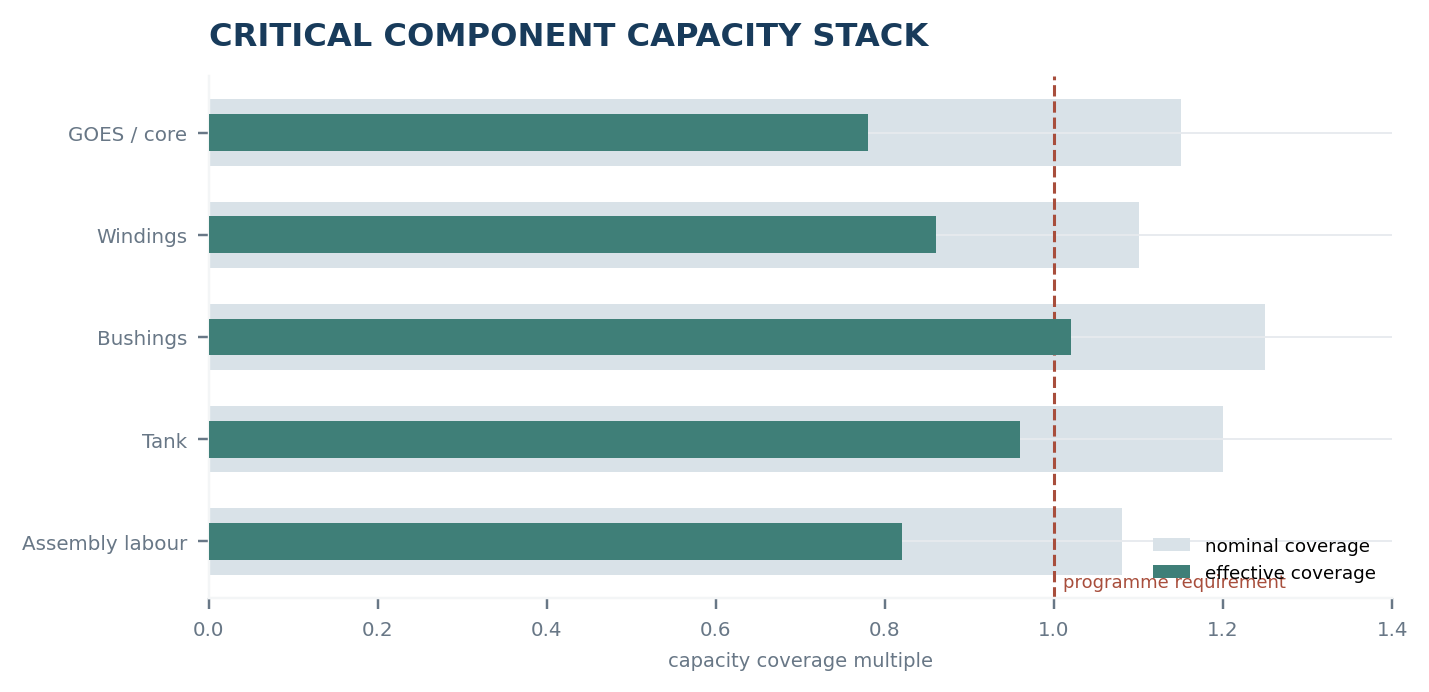

  • Core material and winding throughput constrained different transformer classes.
  • Nominal nameplate capacity overstated supply that was unallocated and available within the programme window.

All values shown are illustrative and would be rebuilt from the agreed product scope and available evidence.

STRESS AND RESPONSE

The model separated material pressure from factory throughput

Electrical-steel allocation, winding throughput, skilled labour and specification changes were applied separately. This showed which schedule risks could be reduced by earlier ordering and which required an alternate design or supplier-development action.

Response logic

Decision point

Action

Order sequence

release constrained classes earlier than their project installation date

Specification

standardise designs where engineering and operating needs allow

Supplier development

qualify one additional pad-mounted facility against a defined demand tranche

DECISION OUTCOME

What the analysis would support

ILLUSTRATIVE CONCLUSION Place long-lead orders by transformer class rather than project date, standardise two specifications where operationally acceptable and develop a second compatible facility for the constrained pad-mounted range.

What the client receives

transformer-class demand model

component bottleneck stack

compatible facility shortlist

order timing and allocation plan

monthly capacity watchlist

Delivery

Typical delivery: 8–10 weeks, depending on the number of transformer classes and availability of project demand data.

The final scope is set by the product, geography, tier depth, time horizon and decisions the study must support. Outputs can be supplied as an executive briefing, editable data model and monitoring specification.
